SAP MM / PP / SD ERROR  |  Factory Calendar

Fix SAP Error: Date Comes After End of Valid Factory Calendar

Example message: "28.11.2019 date comes after end of valid factory calendar. (Please correct)" - the exact date in your own error will differ, but the two-part fix below is identical.

This guide covers two related fixes together, because they're often needed side by side: first, confirming the factory calendar is correctly linked to the right country's public holiday calendar (using SCAL), and second, extending the calendar's validity period so it covers the date range your business actually needs. This guide walks through both, then goes deeper into why holiday calendar linking matters for multi-country organizations, a real business scenario, and a full troubleshooting checklist.

✅ Solution 1: SCAL - Select and Confirm the Holiday Calendar

Step 1: Check Factory Calendar

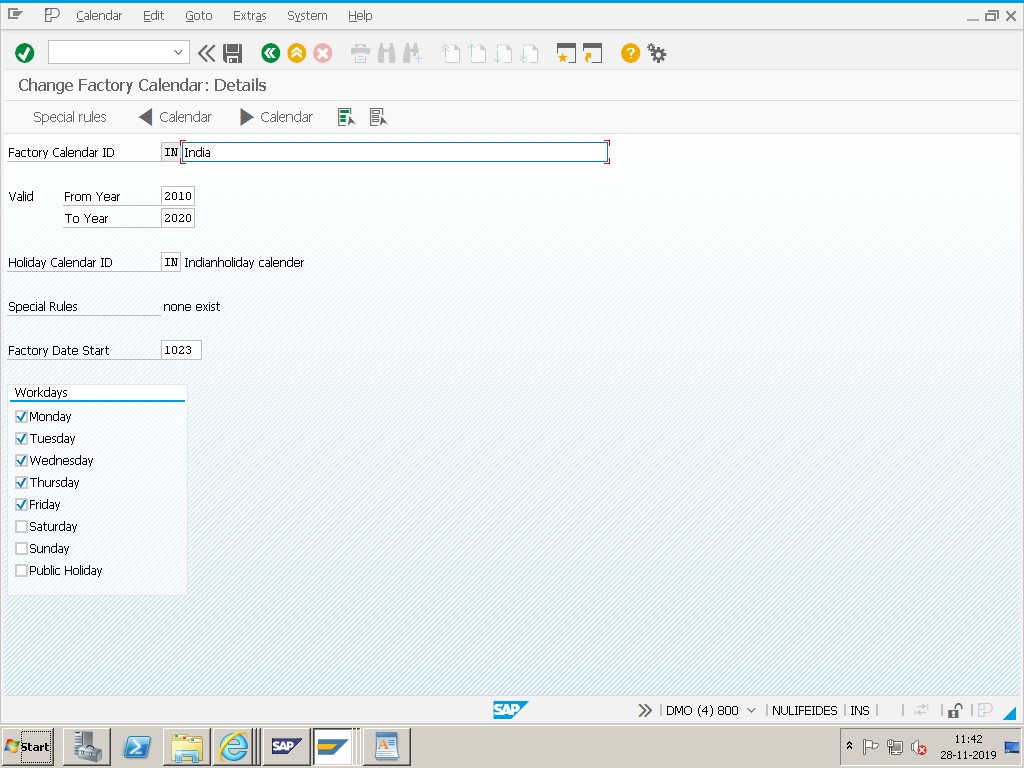

Enter your calendar ID (e.g., IN, US, etc.) and click Change.

SAP SCAL factory calendar ID entry and change screen

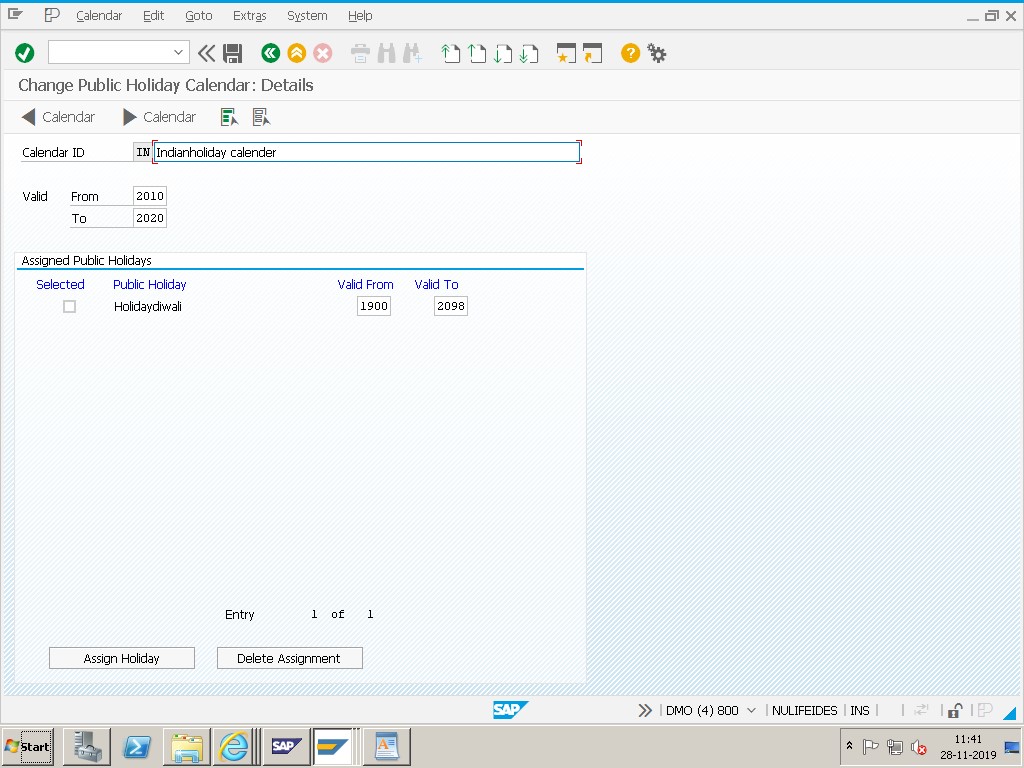

From 2010 to 2020 - check the currently maintained validity range.

SAP SCAL factory calendar validity period from 2010 to 2020

🔧 Then Select Factory Calendar and Link the Correct Holiday Calendar

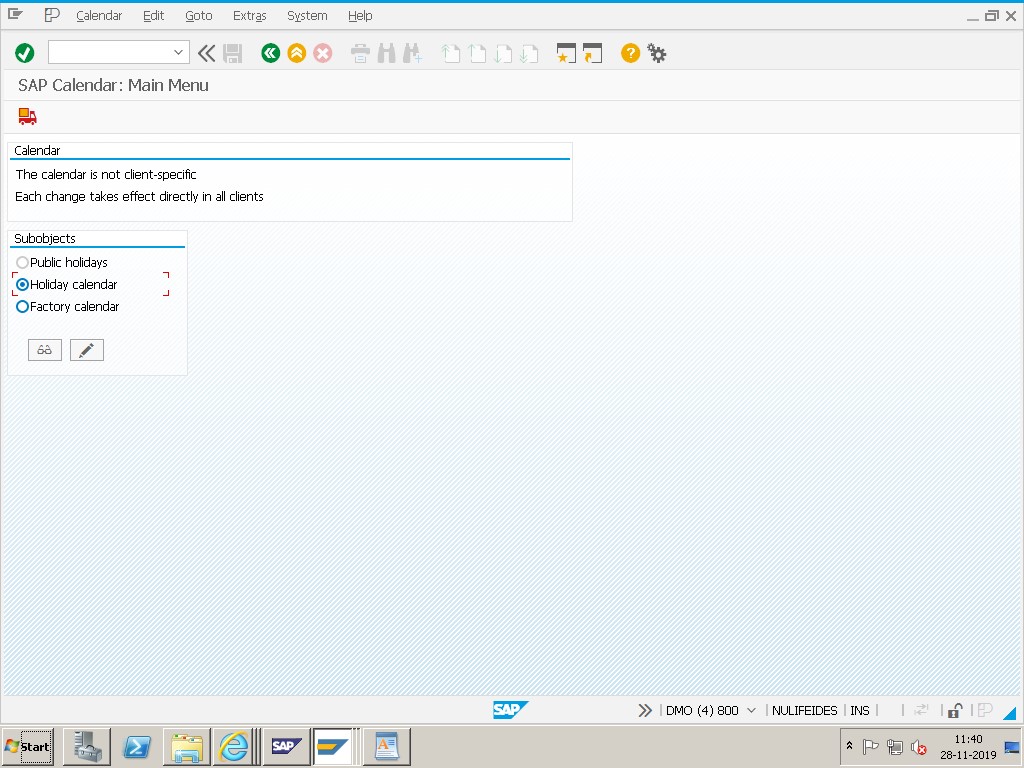

Then select Factory Calendar, then select IN – India (or the appropriate country/region for your plant).

SAP SCAL select factory calendar option SAP SCAL select IN India public holiday calendar

Save.

✅ Solution 2: Extend Calendar Year

Calendar → Change → Validity

Valid To Year → e.g., 2025 / 2030

Save and regenerate the calendar, then retest the original transaction.

🔍 Why Two Separate Fixes Are Covered Together Here

These two solutions address genuinely different aspects of the same underlying problem, and it's worth understanding why both matter. Solution 1 (linking the correct public holiday calendar) ensures the factory calendar's content is accurate - that it correctly reflects the actual holidays observed at that plant's location. Solution 2 (extending validity) ensures the calendar's date range is long enough to be useful for whatever scheduling or planning calculation is trying to use it.

A calendar can have one of these two things wrong without the other: it might be perfectly linked to the right country's holidays but simply not extended far enough into the future (a pure Solution 2 case), or it might have plenty of validity range remaining but be linked to the wrong country's holiday calendar entirely - for example, a plant in India accidentally referencing a US holiday calendar, which wouldn't necessarily throw this exact date-range error but would produce incorrect working-day calculations for every date. Checking both, as this guide does, gives you a complete picture rather than fixing only the symptom that happened to trigger the error message.

📋 Why Holiday Calendar Linking Matters for Multi-Country Organizations

A factory calendar's working-day/non-working-day data isn't invented independently - it's built by combining a public holiday calendar (a list of specific holiday dates for a country or region) with workday rules (typically which weekdays are non-working by default). This means the factory calendar is only as accurate as the holiday calendar it's linked to.

For organizations operating in a single country, this linking step is usually set once during initial system configuration and rarely revisited. But for organizations with plants across multiple countries - as the "select IN – India" step in this guide illustrates - each country typically needs its own factory calendar, correctly linked to that country's specific public holiday calendar, since national holidays (Independence Day, religious observances, regional holidays) differ significantly between countries and even between states or regions within a country. A single shared factory calendar across multiple countries would inevitably get some holidays wrong for at least one location.

ScenarioRecommended Approach
Single-country operationsOne factory calendar per plant, linked to that country's public holiday calendar
Multi-country operationsA separate factory calendar per country (or region, if holidays vary within a country), each correctly linked
Multiple plants within one countryPlants can often share one factory calendar if they observe identical holidays, or use separate calendars if local/regional holidays differ

🛠️ Which SAP Processes Are Affected by an Inaccurate or Expired Calendar

Because working-day calculation underlies so much of SAP's date logic, both problems covered in this guide - insufficient validity and an incorrect holiday calendar link - ripple into several processes at once. MRP scheduling, production and process order dates, capacity planning, route and shipping point scheduling in SD, and purchasing lead time calculations all depend on the plant's factory calendar being both long enough in range and accurate in content. A validity gap tends to produce hard failures (like the error this guide addresses); an incorrect holiday calendar link tends to produce quieter, harder-to-notice scheduling inaccuracies - dates that are technically valid but wrong, like the real scenario described above.

This is worth keeping in mind when prioritizing a fix: a validity error is impossible to ignore because it blocks the transaction outright, while a holiday calendar mismatch can silently produce incorrect schedules for months before someone notices a pattern of orders landing on days the plant is actually closed.

✅ Prevention Checklist for Basis and Planning Teams

📱 This Error in SAP S/4HANA

Factory calendar validity, holiday calendar linking, and the SCAL transaction all work identically in SAP S/4HANA as in ECC, since this is foundational Basis-level configuration shared across every module rather than something restructured by the Universal Journal. Fiori apps that surface scheduling, capacity, or delivery date information all read from the same underlying calendar data, so both the validity and holiday-accuracy issues covered in this guide affect Fiori-based views exactly the same way they affect classic SAP GUI transactions.

📑 How This Page Relates to Other Factory Calendar Guides on This Site

GuideFocus
This page (mmerrorpage12)Validity extension paired specifically with confirming the correct country holiday calendar is linked (the "IN – India" linking step)
Invalid Factory Calendar or Error in the Factory CalendarBroader diagnostic guide covering missing OX10 assignment, expired validity, and misconfiguration as three separate possible causes
Date Comes After End of Factory Calendar (Detailed Guide)Deep dive specifically on validity period mechanics, fixed vs movable holiday rules, and long-term planning implications

All three guides address closely related symptoms, but each emphasizes a different practical angle. If you've already extended validity and the error persists, or if you suspect a holiday accuracy issue rather than a pure date-range problem, this page's holiday calendar linking steps are the most direct next step to check.

💼 Real-World Scenario: A Calendar Extension That Didn't Fully Fix the Problem

Pramod Behera, an SAP Basis consultant, was asked to resolve this exact error for a company's India plant. He extended the factory calendar's validity in SCAL from 2020 through 2030, which immediately resolved the specific error message the planner had reported. A few weeks later, though, the same planner flagged a different, subtler issue: MRP was treating a known Indian public holiday as a working day, causing a planned order to be scheduled on a date the plant would actually be closed.

Investigating further, Pramod found that while the validity extension had fixed the date-range problem, the calendar's link to the IN (India) public holiday calendar had never actually been confirmed - it turned out the factory calendar had been linked to a generic or default holiday calendar during initial setup years earlier, one that didn't include several India-specific holidays. Correcting the holiday calendar link, as covered in Solution 1 of this guide, fixed the underlying scheduling accuracy issue that the validity extension alone hadn't touched. This is exactly why both fixes are covered together in this guide: resolving the visible error message doesn't guarantee the calendar's actual content is correct.

❗ Common Mistakes When Fixing This Error

Tip: Whenever you extend a factory calendar's validity, take the extra minute to also confirm - not just assume - that the correct country/region holiday calendar is linked. The two problems often hide behind the same single error message.

📈 Troubleshooting Decision Tree

📋 Related SAP Transactions

TransactionPurpose
SCALMaintain factory calendars and public holiday calendars, including validity periods and holiday calendar linking.
OX10Assign a factory calendar to a plant.
OP03Alternative path to factory calendar maintenance, referenced in older documentation.
CR02Check or change the factory calendar assigned to a work center's capacity data.
MD01N / MD02Run MRP, sensitive to both calendar validity and holiday calendar accuracy.
MS31 / MS32Long-term planning, often the first process to expose a validity range that's too short.

🎓 Interview-Style Questions and Answers

Q: What two separate things does a factory calendar depend on being correct?
Its validity period (the date range it's been generated for) and the accuracy of the public holiday calendar it's linked to - a calendar can have one correct and the other wrong.

Q: Why might a multinational company need several factory calendars instead of one?
Because national and regional holidays differ significantly between countries, a single factory calendar can't accurately represent working days for plants in different countries - each typically needs its own calendar linked to the correct local holiday calendar.

Q: If a validity extension resolves the error message but a known holiday still shows as a working day, what's the likely next step?
Check the holiday calendar link for that factory calendar in SCAL - the date-range problem and the holiday-accuracy problem are separate issues that can exist independently of each other.

📚 Quick Glossary of Terms Used in This Guide

🎯 Conclusion

"Date comes after end of valid factory calendar" is usually fixed by extending validity, but a thorough fix also confirms the calendar is linked to the correct country or region's holiday calendar - otherwise, you may resolve the visible error while leaving a quieter, harder-to-spot scheduling accuracy problem behind. Treat both solutions in this guide as a package, especially the first time you touch a given plant's factory calendar, and extend validity generously so you're not repeating this exercise again next year.

❓ Frequently Asked Questions

It means a process tried to calculate or reference a date that falls beyond the validity period currently generated for the assigned factory calendar, so SAP cannot determine whether that date is a working day. The fix is either extending the calendar's validity period, or correcting which holiday calendar it's linked to if the calendar itself is misconfigured.
Go to transaction SCAL, select the factory calendar ID, click Change, update the Valid From and Valid To year fields to cover the required range (for example, extending to 2025 or 2030), then save and regenerate the calendar.
A factory calendar's working/non-working days are built by combining a public holiday calendar (like IN for India) with workday rules. If the wrong holiday calendar is linked, or none is linked at all, the factory calendar may not correctly reflect the actual holidays for that plant's country or region.
A single factory calendar is generally linked to one holiday calendar representing one country or region's holidays. Organizations with plants in multiple countries typically maintain a separate factory calendar per country or region, each linked to the appropriate local public holiday calendar.
The date error itself may disappear once the validity period covers the required date, but the calendar could still mark the wrong days as holidays or working days if it references an incorrect or missing holiday calendar, leading to scheduling that doesn't match your actual business calendar.
Extend it generously - a common practice is maintaining validity 5 to 10 years into the future - rather than just past the immediate failing date, to avoid repeating the same extension exercise again soon.
