SAP PP ERROR  |  Factory Calendar

SAP Error: Date Comes After End of Factory Calendar with ID 01 - Solution Guide

Example message: "Date 01.11.2024 comes after end of factory calendar with ID 01" - the exact date and calendar ID in your own error will differ, but the fix below is identical.

This common error means that the factory calendar (ID 01 in this example) assigned to your system does not include the date being referenced. This guide covers the exact fix using SCAL, then goes deeper into what a factory calendar actually is, how it differs from a public holiday calendar, which SAP processes depend on it, a real business scenario, and a full prevention checklist so this doesn't keep recurring year after year.

✅ Possible Causes

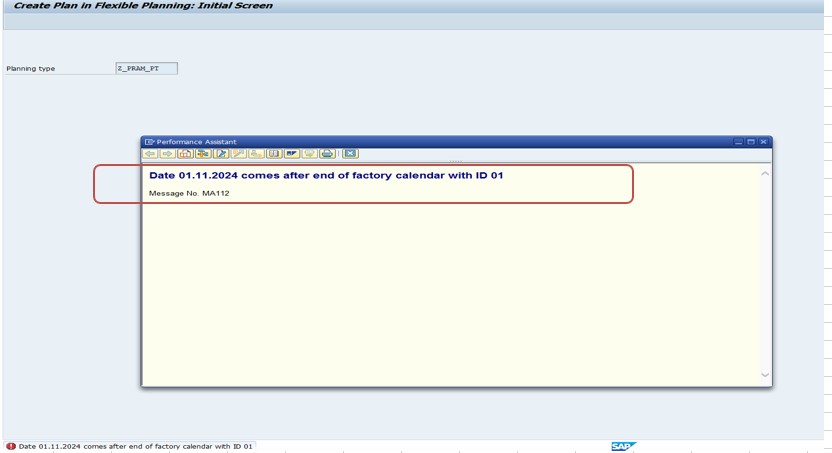

SAP error: date comes after end of factory calendar with ID 01
SAP SCAL factory calendar validity period screen SAP factory calendar working days configuration

🔧 Follow These Steps

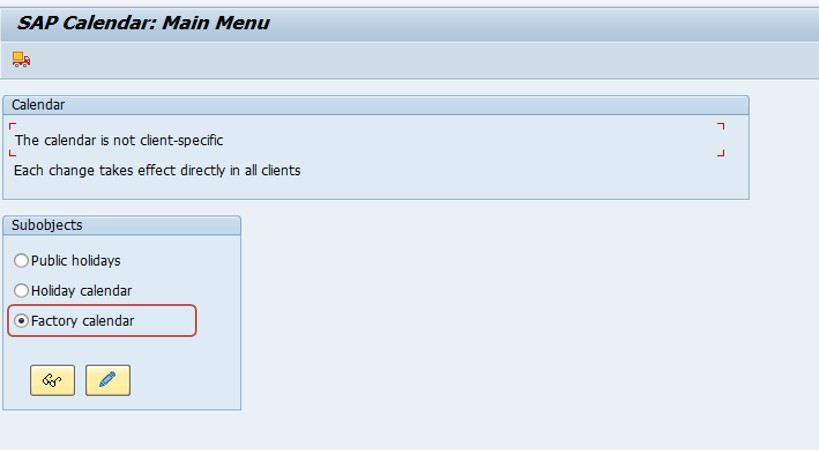

Solution: Go to SAP transaction SCAL (Factory Calendar Maintenance).

1

Go to transaction SCAL (Factory Calendar Maintenance).

2

Locate Factory Calendar ID 01 and click Change (Edit mode).

SAP SCAL transaction locating factory calendar ID 01 in change mode
3

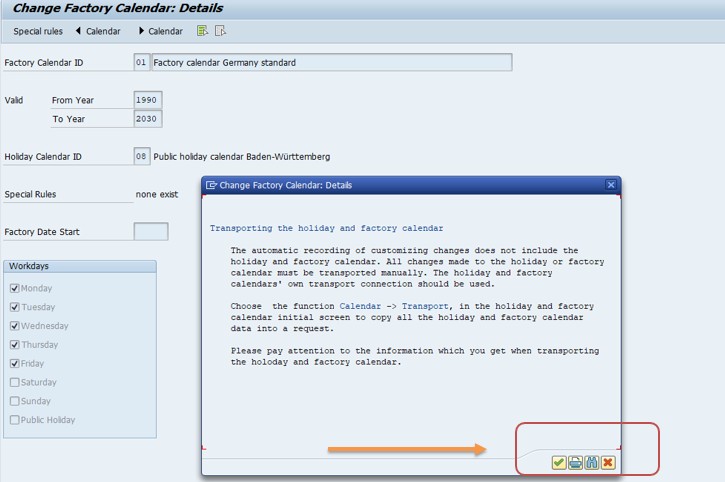

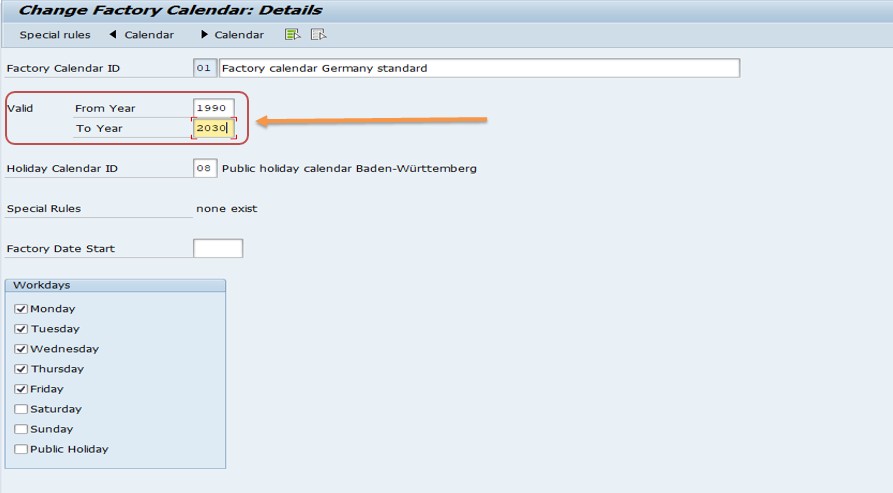

Extend the validity period - for example, update it to cover 1990 to 2030 - then save.

SAP SCAL extending factory calendar validity period
4

Save and retest the original transaction that raised the error.

🔍 What a Factory Calendar Actually Is, and Why It Has an End Date

A factory calendar in SAP defines which calendar dates count as working days and which count as non-working days for a specific plant, work center, or business process. It's built from two components: a public holiday calendar (a list of specific holiday dates, either fixed to a date every year or tied to a movable date rule) and a set of workday rules (typically which weekdays, like Saturday and Sunday, are treated as non-working by default). Both of these are maintained together in transaction SCAL.

Crucially, a factory calendar is not open-ended - it is generated with an explicit validity period, meaning SAP calculates and stores the working-day status for every date within that range when the calendar is generated, rather than calculating it on the fly indefinitely into the future. This is a deliberate design choice for performance and predictability, but it means that once your business processes need to schedule or calculate a date beyond that pre-generated range, SAP has nothing to reference and raises exactly the error this guide addresses.

📑 Factory Calendar vs Public Holiday Calendar - What's the Difference?

AspectPublic Holiday CalendarFactory Calendar
What it definesA list of specific holiday dates (fixed or rule-based, e.g. "second Monday of October")A complete working-day/non-working-day schedule combining holidays and weekday rules
Where it's maintainedSCAL, Public Holidays tabSCAL, Factory Calendar tab, referencing a holiday calendar
What it's assigned toNothing directly - it's a building blockPlants, work centers, and other date-sensitive master data
Has a validity period?Yes, per holiday ruleYes, and this is the validity period referenced in this error

In practice, when this error appears, the actual object that needs extending is always the factory calendar itself (via its own dedicated validity fields in SCAL), not the underlying public holiday calendar - though if the holiday calendar it references also has a shorter validity period, that may need extending too for the factory calendar regeneration to succeed cleanly.

🛠️ Which SAP Processes Depend on the Factory Calendar

Because working-day calculation touches almost every date-sensitive process in SAP, a factory calendar running out of validity can surface in several different-looking errors depending on which process hits the limit first.

This is exactly why extending a factory calendar's validity period is not a narrow, one-off fix for a single error message - it's effectively a piece of ongoing system maintenance that keeps a wide range of planning and scheduling processes working correctly.

📅 How Public Holidays Are Defined: Fixed vs Movable Rules

When maintaining the underlying public holiday calendar in SCAL, each holiday can be defined one of two ways, and understanding the difference helps when troubleshooting why a specific date is or isn't treated as a holiday after an extension. A fixed date holiday falls on the same calendar date every year (for example, a national day always on a specific day and month), and SAP simply repeats it automatically for every year within the calendar's validity period. A movable holiday is defined by a rule rather than a fixed date - for example, "Easter Sunday plus one day," or "the fourth Thursday of November" - and SAP calculates the actual date for each year based on that rule.

This matters for troubleshooting because a factory calendar extension can sometimes reveal that a movable holiday rule was configured incorrectly or is missing entirely for the newly extended years, especially for holidays tied to lunar or other non-Gregorian calculations that some organizations maintain manually rather than through a built-in SAP rule. If a newly extended calendar year shows a working day where a known holiday should fall, checking the specific holiday rule in SCAL - not just the factory calendar's overall validity - is the next place to look.

📈 Troubleshooting Decision Tree

📱 Factory Calendars in SAP S/4HANA

Factory calendar maintenance via SCAL, and the underlying concept of a validity-bound, pre-generated working-day schedule, is unchanged in SAP S/4HANA - this is foundational Basis-level configuration shared across all SAP modules rather than something tied to the Universal Journal or Fiori. Fiori apps that surface scheduling, capacity, or delivery date information (such as production scheduling boards or the Manage Production Orders app) all read from the same underlying factory calendar data, so a validity gap will surface consistently whether your team works in classic SAP GUI or through Fiori.

One S/4HANA-adjacent consideration: if your organization has adopted Advanced Available-to-Promise (aATP) or advanced production scheduling tools that run further-out simulations by design, factory calendar validity gaps can surface earlier and more visibly than they did under classic ECC processes, simply because these newer planning tools are more likely to reach further into the future during normal operation. It's worth proactively extending factory calendars well ahead of adopting any new long-range planning or scheduling tool.

📑 Similar-Looking SAP Factory Calendar Errors and How They Differ

ErrorRoot CauseTypical Fix
Date comes after end of factory calendar with ID XThe calendar's validity period doesn't extend far enough forwardExtend the validity period in SCAL and regenerate
Invalid factory calendar or error in the factory calendarThe calendar itself may be incompletely configured, corrupted, or missing a required holiday ruleReview the calendar's configuration in SCAL for missing or invalid entries, not just its date range
Date comes after end of valid factory calendar (please correct)Functionally the same family of issue as this page's error, just phrased slightly differently depending on the calling transactionSame fix: extend validity in SCAL

These three messages are closely related and sometimes confused with one another because they all originate from the same underlying factory calendar logic - if extending the validity period doesn't resolve your specific error, it's worth checking whether you're actually facing a configuration completeness issue (missing holiday rules or an incorrectly assigned holiday calendar) rather than a pure validity range problem.

💼 Real-World Scenario: A Long-Term Planning Run Fails Unexpectedly

Pooja Mishra, a production planner at a heavy equipment manufacturer, was running a long-term planning (LTP) simulation to forecast capacity needs three years out, as part of an annual budgeting exercise. The simulation failed midway through with a factory calendar error referencing a date well beyond what she expected to be an issue, since day-to-day MRP runs had never shown any calendar problems.

Investigating with her Basis team, she learned that the plant's factory calendar had been generated years earlier with a validity period ending just two years into the future - comfortably enough for normal day-to-day scheduling, but not nearly far enough for a multi-year long-term planning simulation. The team extended the calendar's validity to run a full decade forward in SCAL, regenerated it, and reran the simulation successfully. This is a common pattern: short-range operational processes can run for years without ever hitting a calendar's end date, while a longer-range planning, forecasting, or reporting exercise can suddenly expose a validity gap nobody had reason to notice before.

❗ Common Mistakes When Fixing This Error

Tip: When extending a factory calendar, extend it generously - many organizations standardize on maintaining calendars 5 to 10 years into the future, which avoids repeating this exact fix year after year.

✅ Prevention Checklist for Basis and PP Teams

📋 Related SAP Transactions

TransactionPurpose
SCALMaintain factory calendars and public holiday calendars, including validity periods.
OX10Check which factory calendar is assigned to a plant.
CR02Check or change the factory calendar assigned to a work center's capacity data.
MD01N / MD02Run MRP, which relies on the plant's factory calendar for scheduling.
MS31 / MS32Create or change a long-term planning scenario, sensitive to factory calendar validity for multi-year simulations.
CM01 / CM07Capacity evaluation and leveling, dependent on factory calendar working days at work centers.

🎓 Interview-Style Questions and Answers

Q: Why does a factory calendar have a defined validity period instead of calculating working days indefinitely?
SAP pre-generates and stores the working-day status for every date within the calendar's validity range for performance and consistency, rather than recalculating holiday and weekday rules on the fly for every date lookup, which means the calendar must be periodically extended and regenerated to remain useful.

Q: What is the relationship between a factory calendar and a public holiday calendar?
A factory calendar combines a public holiday calendar (specific holiday dates) with workday rules (which weekdays are working days) into a single, plant- or work-center-assignable calendar with its own validity period.

Q: If MRP fails with a factory calendar error but day-to-day operations have been fine, what's the likely explanation?
The calendar's validity period likely covers near-term dates comfortably but doesn't extend far enough for whatever longer-range calculation MRP (or a related process like long-term planning) is now trying to perform, such as a long lead time offset or a multi-period planning horizon.

📚 Quick Glossary of Terms Used in This Guide

🎯 Conclusion

"Date comes after end of factory calendar" is a routine maintenance issue, not a system malfunction - SAP factory calendars are deliberately generated with a fixed validity period, and that period simply needs periodic extension as time passes. By understanding what a factory calendar actually represents, which processes depend on it, and extending it generously rather than just enough to silence today's error, you can turn this from a recurring annual annoyance into a fix you make once and revisit only during scheduled maintenance.

❓ Frequently Asked Questions

It means a process - such as MRP scheduling, a production order, or capacity planning - tried to calculate or reference a date that falls beyond the validity period currently maintained for the assigned factory calendar, so SAP cannot determine whether that date is a working day or not.
Go to transaction SCAL, locate the factory calendar ID referenced in the error, switch to change mode, and extend the calendar's validity period to cover the required date range, then save and regenerate the calendar.
A factory calendar defines which dates are working days and which are non-working days (weekends and holidays) for a plant or work center, and is built from a public holiday calendar plus a defined validity period and workday rule.
A public holiday calendar lists specific holiday dates, which can recur every year or be fixed to a specific date. A factory calendar combines a public holiday calendar with workday rules and its own validity period, and it's the factory calendar that plants and work centers are assigned to.
MRP scheduling, production order and process order scheduling, capacity planning at work centers, route/shipping point determination in SD, and any date calculation that relies on counting working days can all fail or produce unreliable results once they need a date beyond the calendar's maintained validity period.
There's no fixed SAP rule, but a common practice is to maintain factory calendars several years beyond the current date - many organizations extend calendars 5 to 10 years out during setup and review them annually.
