SAP MM CONFIGURATION  |  Transaction OME1

Define Purchasing Value Key in SAP MM (T-code OME1) -Step-by-Step Guide

Every material a buyer procures needs a consistent answer to two recurring questions: when should a vendor be reminded about a late delivery, and how much price or quantity variance is acceptable before an invoice gets blocked? Purchasing value keys answer both automatically. This guide walks through the OME1 configuration path, the reminder and tolerance logic behind each key, and the mistakes that cause missed reminders or unnecessary invoice blocks later.

⚠ What Is a Purchasing Value Key in SAP MM?

A purchasing value key is a small but powerful configuration object assigned on the purchasing view of a material master record. It bundles together a set of purchasing control defaults - primarily reminder levels for chasing overdue vendor deliveries and tolerance percentages for order price and quantity variance - so buyers don't have to configure these values manually on every single purchase order or invoice. Instead, the key is set up once through transaction OME1 and then reused across every material that needs the same purchasing behavior.

Think of it as a purchasing rulebook attached quietly to a material: how many days after the promised delivery date should the system flag a reminder letter to the vendor, and how far can an invoiced price or quantity drift from what was ordered before someone in accounts payable needs to look at it. Without a purchasing value key, these checks either rely entirely on system-wide defaults or require manual attention on every transaction, both of which slow down a high-volume procurement operation.

Why This Configuration Matters Beyond a Convenience Setting

It's tempting to treat purchasing value keys as a minor administrative shortcut, but in practice they directly influence two areas that matter to procurement performance: on-time delivery follow-up and invoice accuracy control. A material with no reminder levels configured might never trigger an automatic follow-up letter when a vendor misses a delivery date, quietly extending lead times without anyone noticing until stock runs low. A material with tolerance limits set too wide might let genuinely incorrect invoices pass straight through without review, creating a slow financial leak that's difficult to trace back to its source.

📋 Where OME1 Fits in the Material Master and Procurement Cycle

The purchasing value key sits on the purchasing view of the material master, alongside other purchasing-specific defaults like purchasing group and order unit. Once assigned, it quietly influences behavior at two distinct points later in the procure-to-pay cycle.

StageHow the Purchasing Value Key Is Used
Material Master (Purchasing View)The key is assigned once, carrying its reminder and tolerance settings for every future transaction involving that material
Purchase Order Follow-UpSAP proposes reminder letters to the vendor at the configured day intervals when a delivery becomes overdue
Invoice VerificationThe system compares the invoiced price and quantity against the purchase order, applying the configured tolerance percentages to decide whether the invoice needs manual review

Because the key is referenced automatically at both of these points, a single well-designed purchasing value key can save a procurement team from dozens of manual reminder calls and invoice queries every month.

💼 Business Scenario: Why Purchasing Value Keys Matter

Picture a manufacturing company sourcing a critical raw material from a vendor with a history of occasionally slipping delivery dates. Without a purchasing value key configured with sensible reminder levels, the procurement team relies on someone manually tracking delivery dates in a spreadsheet and calling the vendor when a shipment looks late - a process that's easy to forget during a busy week. By configuring a purchasing value key with staged reminder levels, for example at 5, 10, and 15 days overdue, SAP automatically proposes increasingly urgent reminder letters to the vendor without anyone needing to track the date manually.

On the invoice side, the same company might negotiate a small acceptable variance in price due to currency fluctuation, but wants anything beyond 2% flagged for review before payment is released. Configuring that tolerance once in the purchasing value key, rather than trusting every accounts payable clerk to remember the acceptable threshold, keeps invoice verification consistent and defensible during an audit.

✅ Prerequisites Before Running OME1

🛠️ Step-by-Step: Defining a Purchasing Value Key Using OME1

1

Open the Configuration Path

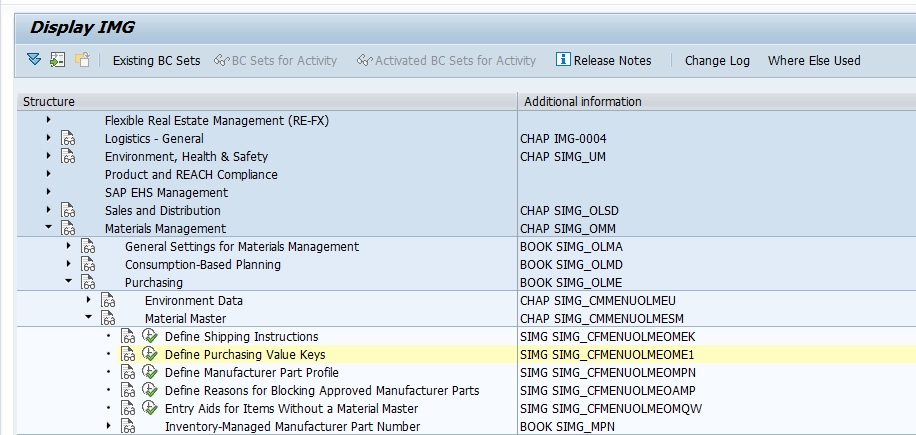

Log in with customizing access, then type OME1 directly into the transaction box, or follow SPRO > Materials Management > Purchasing > Material Master > Define Purchasing Value Key.

SPRO navigation path to define purchasing value key using OME1 in SAP MM
2

Select New Entries
On the overview screen listing every existing purchasing value key, click New Entries to build a fresh key. Assign a short, two-character code - for example key 8 - to represent this new set of reminder and tolerance defaults.

OME1 new entries screen for creating purchasing value key 8 in SAP
3

Configure Reminder Levels and Tolerance Settings

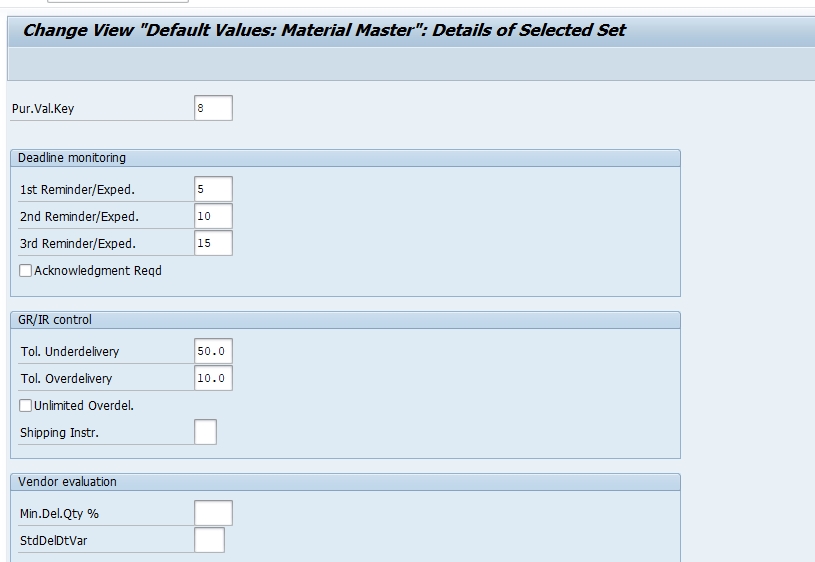

For purchasing value key 8, set the first reminder at 5 days, the second reminder at 10 days, and the third reminder at 15 days overdue, staging progressively more urgent follow-up communication with the vendor. Alongside these reminder levels, configure the order price and quantity variance tolerance percentages that determine when an invoice should be flagged for manual review.

Configuring purchasing value key 8 with 5 10 15 day reminder levels in SAP OME1
4

Save and Assign to a Transport Request
Click Save. SAP prompts you to capture the change under a customizing transport request. Assign it with a clear description, for example "Create purchasing value key 8 with 5/10/15 day reminders," and release it once testing is complete.

5

Assign the Key to Relevant Material Master Records
Once confirmed in OME1, assign the purchasing value key on the purchasing view of every material master record that should follow this reminder and tolerance pattern, so it defaults automatically onto future purchase orders and invoice checks for those materials.

⚙️ Understanding the Fields Inside a Purchasing Value Key

FieldPurpose
Purchasing Value KeyThe two-character code representing this specific combination of reminder and tolerance settings
1st Reminder / UrgingNumber of days after the delivery due date at which SAP proposes the first reminder letter to the vendor
2nd Reminder / UrgingNumber of days for the second, more urgent reminder if the delivery is still outstanding
3rd Reminder / UrgingNumber of days for the final reminder level before further escalation is typically handled manually
Order Price Quantity VarianceThe permitted percentage deviation between invoiced and ordered price or quantity before the invoice is blocked for review
Shipping InstructionsAn optional default indicating packaging or shipping notes relevant to materials using this key

Using the example from the screenshots above, purchasing value key 8 with reminders at 5, 10, and 15 days gives the procurement team a clear, automatically staged follow-up schedule for every material assigned to that key, without requiring any manual date tracking.

📦 Where a Purchasing Value Key Gets Used Once Assigned

After a purchasing value key is configured and assigned to a material master record, its effects show up in a few distinct places during day-to-day procurement operations.

⚠️ Common Errors and How to Resolve Them

"Purchasing value key already exists"

Another consultant may have already created a key with the same code, possibly with different reminder or tolerance settings. Search the existing table first before assuming a new key is genuinely needed.

Vendor reminders not being generated as expected

Check whether the purchasing value key is actually assigned on the material master purchasing view, since the key configured in OME1 has no effect until it's referenced by a material. Also confirm the reminder proposal report is being run regularly by the procurement team.

Invoices blocking too frequently, or not blocking when they should

This almost always traces back to the order price and quantity variance tolerance percentages configured in the key rather than a problem in invoice verification itself. Review the tolerance values against what finance actually agreed to before assuming a system defect.

Entry saves without a transport request

In a sandbox or standalone client, changes may save locally. In a proper landscape, always confirm the change was captured in a transport request, otherwise it won't migrate forward to quality assurance or production.

🔗 Related SAP MM Transaction Codes

T-codePurpose
OME1Define purchasing value key
MM02Change material master record, where the purchasing value key is assigned on the purchasing view
ME21NCreate purchase order, indirectly influenced by the purchasing value key's reminder settings
MIROEnter incoming invoice, where the tolerance settings from the purchasing value key are checked
OMR6Configure system-wide tolerance keys used alongside material-specific purchasing value key settings
ME91FPrint or generate purchase order reminder letters based on configured reminder levels

Reviewing this table alongside your project's blueprint confirms every dependent configuration node has been completed before material master data loading begins.

🏢 Purchasing Value Key vs Vendor Evaluation - Two Different Purposes

What Purchasing Value Key Controls

A purchasing value key operates at the material level, defining reminder timing and tolerance limits that apply consistently to every transaction involving that specific material, regardless of which vendor supplies it.

What Vendor Evaluation Controls

Vendor evaluation, configured through a separate set of transactions, scores a vendor's overall performance across criteria like price, quality, delivery timeliness, and service, aggregated across all the materials and transactions tied to that vendor rather than any single material.

How They Complement Each Other

In practice, the reminder history generated because of a purchasing value key's settings can indirectly feed into a vendor's delivery performance score under vendor evaluation, making the two features complementary rather than competing. A material with a tightly configured purchasing value key helps ensure vendor evaluation data is captured consistently, since reminders and variances are flagged the same way every time rather than depending on manual attention.

🔒 Authorization Considerations for Maintaining OME1

Because purchasing value keys affect both vendor communication timing and invoice blocking behavior, access to this configuration should be restricted to functional consultants or configuration leads with a documented change process behind every edit. Tolerance percentages set too loosely can silently let incorrect invoices through for months before finance notices a pattern in vendor overbilling.

📅 How OME1 Fits Into a Broader Implementation Timeline

Purchasing value key configuration typically happens during the Materials Management purchasing setup phase, alongside terms of payment, Incoterms, and material type configuration, well before material master data loading begins. Because a purchasing value key can be assigned across many materials at once, most project plans define only a handful of keys representing common reminder and tolerance patterns rather than a unique key per material.

This configuration also resurfaces when a business renegotiates delivery expectations or invoice tolerance policy with a category of vendors, requiring either a new purchasing value key or an adjustment to an existing one, followed by reassignment across the relevant material master records.

✅ Testing Checklist After Configuring OME1

❓ Common Misconceptions About Purchasing Value Key Configuration

📖 Glossary of Key Terms

TermMeaning
Purchasing Value KeyA configuration key bundling reminder levels and tolerance settings, assigned on the material master purchasing view
Reminder Level / Urging LevelThe number of days after a delivery due date at which SAP proposes a follow-up letter to the vendor
Order Price VarianceThe difference between the invoiced price and the price stated on the purchase order
Quantity VarianceThe difference between the invoiced quantity and the quantity stated on the purchase order or goods receipt
Invoice BlockA hold placed on an invoice during verification when a discrepancy exceeds configured tolerance
Vendor EvaluationA separate SAP MM function scoring overall vendor performance across price, quality, delivery, and service

🔍 Case Study: Reducing Late Deliveries Traced to Missing Reminder Configuration

A packaging materials company noticed a recurring pattern of stock-outs on a specific raw material despite purchase orders being placed well ahead of the required date. Investigation revealed that the material master record for that item had no purchasing value key assigned at all, meaning no automatic reminder letters were ever proposed when the vendor's deliveries slipped past the agreed date. Buyers were relying entirely on memory to notice late shipments, and with dozens of open purchase orders active at any time, this particular vendor's slow but recurring delays kept going unnoticed until stock ran critically low.

The fix involved creating a purchasing value key with reminder levels staged at 5, 10, and 15 days overdue, then assigning it to the affected material and several others sourced from the same vendor. Within the following month, the automatically generated reminder letters gave the procurement team a consistent, system-driven prompt to follow up, and the frequency of stock-outs for that material dropped noticeably. This case illustrates why reviewing which materials have a purchasing value key assigned is worth doing periodically, not just during initial project configuration.

💡 Key Takeaways

❓ Frequently Asked Questions

Also A purchasing value key in SAP is a configuration key stored on the material master purchasing view that bundles together reminder levels for overdue deliveries, tolerance limits for order price and quantity variance, and other purchasing control defaults, so buyers don't have to set these values manually on every purchase order.
Go to SPRO > Materials Management > Purchasing > Material Master > Define Purchasing Value Key, or run transaction OME1 directly. Select New Entries, assign a two-character key, configure the reminder days and tolerance percentages, then save and assign the change to a transport request.
Reminder levels, also called urging or expediting levels, are the number of days before or after a delivery due date at which SAP proposes sending an automatic reminder letter to the vendor. A purchasing value key can hold up to three reminder levels, commonly staged like 5, 10, and 15 days.
Once configured in OME1, a purchasing value key is assigned on the purchasing view of the material master record, and its reminder and tolerance settings apply automatically to purchase orders and goods receipts created for that material.
Order price quantity variance tolerance is the permitted percentage deviation between the invoiced price and the purchase order price before the system blocks an invoice for manual review during invoice verification.
No. The purchasing value key field on the material master purchasing view is optional. If left blank, SAP falls back to system-wide default tolerance and reminder settings rather than material-specific overrides.
A purchasing value key controls reminder timing and tolerance limits at the material level, while vendor evaluation is a separate SAP MM function that scores a vendor's overall performance across price, quality, delivery, and service using a completely different configuration path.
Yes. A purchasing value key is created once in OME1 and can be assigned to as many material master records as needed, which is exactly why most organizations define only a handful of purchasing value keys representing common tolerance and reminder patterns.
The underlying purchasing value key configuration table and transaction OME1 remain functionally consistent between SAP ECC and SAP S/4HANA, since this is foundational Materials Management customizing that has not changed significantly across releases.
Setting tolerance limits too wide means invoices with meaningful price or quantity discrepancies pass through invoice verification without being flagged for review, which can allow overbilling or short deliveries to go unnoticed until a much larger reporting gap surfaces later.
