SAP PP ERROR SOLUTION  |  Production Order Scheduling (OPU3)

SAP Error: "Scheduling Parameters Are Not Defined for Production Orders" – Causes and Step-by-Step Fix

A planner converts a planned order, or a shop floor clerk creates a production order in CO01, and SAP stops with a message about missing scheduling parameters. The material is fine, the routing is complete and the bill of material is in place, yet the order will not be created. The reason is not in the master data at all. It is a small configuration entry that tells SAP how to calculate dates for a given plant and order type. This guide explains what scheduling parameters are, why the system needs them, how to define them in transaction OPU3 step by step, and how to avoid the mistakes that cause the error to return. If you run into any errors while following along, feel free to send a screenshot to pramod@learntosap.com for help.

❌ The Error Message at a Glance

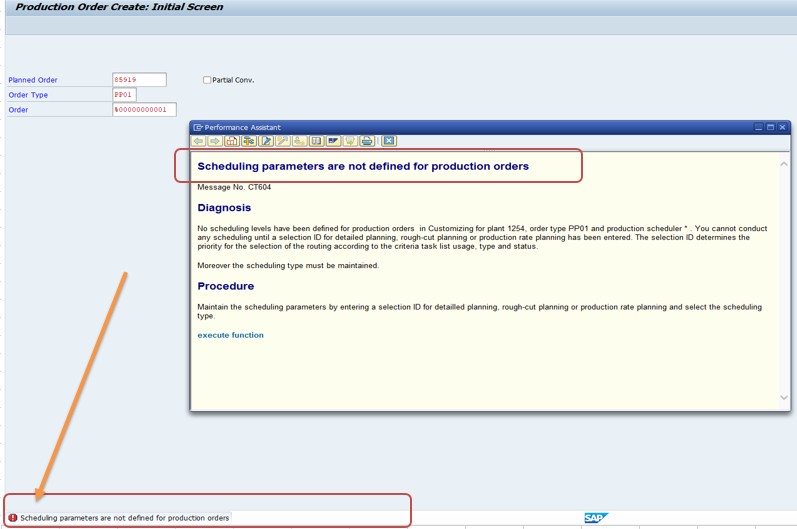

SAP error message scheduling parameters are not defined for production orders
ItemValue in This Example
Message textScheduling parameters are not defined for production orders
ModuleSAP PP, shop floor control
Plant1254
Order typePP01, standard production order
Where to fix itOPU3, Define Scheduling Parameters for Production Orders
Message typeError: the order cannot be created until the entry exists

The error means that SAP is missing scheduling settings for production orders for the plant or the order type in use. It appears when the system tries to calculate the dates of a new order and cannot find a matching configuration entry. The plant and order type in your own message may differ from this example, but the fix is the same.

📑 What You Will Learn in This Guide

  1. What the error means
  2. What scheduling parameters are
  3. Scheduling types explained
  4. Why the error appears
  5. Where you meet the error
  6. Diagnose the problem
  7. Solution: define parameters in OPU3
  8. Verify the fix
  9. Worked scheduling example
  10. Real-world scenario
  11. Master data that affects scheduling
  12. Common mistakes
  13. Troubleshooting
  14. How to prevent the error
  15. Frequently asked questions

✅ What Does "Scheduling Parameters Are Not Defined for Production Orders" Mean?

Whenever you create or change a production order, SAP calculates its dates. It needs to know when production should start, when it should finish and how long each operation takes. To do this it reads a configuration entry called the scheduling parameters, which is stored per plant, order type and production scheduler. If no matching entry exists, the system cannot decide how to schedule the order and stops with this message.

The key point is that the problem lies in Customizing and not in master data. You can have a perfect material, a correct routing and a complete bill of material, and the error will still appear. Changing the order, the material or the routing will not help, because the missing information is not there. The fix is to create the missing entry in the configuration, which is exactly what transaction OPU3 is for.

The error is common in new systems, new plants and new order types, where the master data has been loaded but nobody has yet configured how the orders should be scheduled. It also appears after a plant is copied, because the copy does not always include every production setting.

📝 What Are Scheduling Parameters in SAP PP?

Scheduling parameters are a set of rules that control how SAP schedules production orders. They are defined for each combination of plant, order type and production scheduler, and they answer questions such as: Should the system schedule forwards or backwards? Should it schedule automatically when an order is saved? How should it handle dates in the past?

Key FieldExampleMeaning
Plant1254The plant for which the rule applies.
Order typePP01The type of production order, here the standard production order.
Production scheduler*The person or group responsible for planning. The star means all schedulers.
ParameterExampleMeaning
Scheduling typeBackwardThe direction in which dates are calculated.
Automatic schedulingTickedSAP schedules the order automatically when it is created or changed.

A real system may show more fields, such as how to handle start dates in the past, how to adjust dates after scheduling and which reduction strategy to use. Those are refinements. The two settings in the table are the minimum needed to make the error disappear and to give SAP a clear direction.

💡 Scheduling Types Explained: Forward, Backward and Others

The scheduling type is the most important setting. It tells SAP where to start the calculation. The options below are the ones most often found in standard configuration.

Scheduling TypeHow It WorksWhen to Use It
BackwardStarts from the required finish date and calculates back to the start date.When orders must be ready by a due date, such as a customer delivery.
ForwardStarts from the start date and calculates the earliest finish date.When material is available now and you want to know when the order could be done.
Current dateUses today as the starting point of the calculation.For urgent orders or orders created late.
Only capacity requirementsCalculates the capacity requirements without changing the order dates.When dates are fixed and only the load needs to be known.

Backward scheduling is a sensible default for most make-to-stock and make-to-order scenarios, because planning usually begins with a demand date. That is why it is chosen in the example. Your company may prefer another type, and the right answer depends on how your planners work. Check the options available in your release in the dropdown of OPU3.

Tip: If you are unsure, ask the production planner one simple question: "Do you plan from the due date back, or from the start date forward?" The answer decides the scheduling type.

💡 Why Does This Error Appear? Common Causes

The error message often also prompts users to look at the material master, and the Work scheduling view of MM02 does contain a production scheduling profile. That profile is a different setting. It is worth checking, and the section on master data below explains how. But in the classic case described here, the missing piece is the plant and order type entry in OPU3.

📋 Where You Meet This Error in Daily Work

ActivityTypical Transaction
Creating a production order with materialCO01
Creating a production order without materialCO07
Creating an order for a sales orderCO08
Converting a planned order to a production orderMD04, CO40, CO41
Rescheduling an existing orderCO02

The error appears at the moment the system tries to determine dates, which is why it often shows up during conversion of planned orders. In a collective conversion, one missing entry can block many orders at once, so a quick fix saves a lot of time.

🔧 Step-by-Step: Diagnose the Problem

1

Read the message and note the context. Which transaction were you in, which plant, and which order type? In CO01 the plant and order type are on the initial screen.

2

Find the production scheduler. It comes from the material master, in the MRP 1 view, and is copied into the order. Note it down, since the entry you need depends on it.

3

Open OPU3 in display mode and look for an entry with your plant and order type. If none exists, you have found the cause. If one exists for a different scheduler only, you need a star entry or one for your scheduler.

4

Compare with a working plant. If another plant creates orders without problems, open its OPU3 entry and copy its logic, after checking that it makes sense for your plant.

Note: Always diagnose before you change anything. Adding a star entry for all schedulers is quick, but it may override a deliberate setup, so know what already exists first.

🔧 Solution: Define Scheduling Parameters in OPU3

Follow these steps to create the missing entry.

1

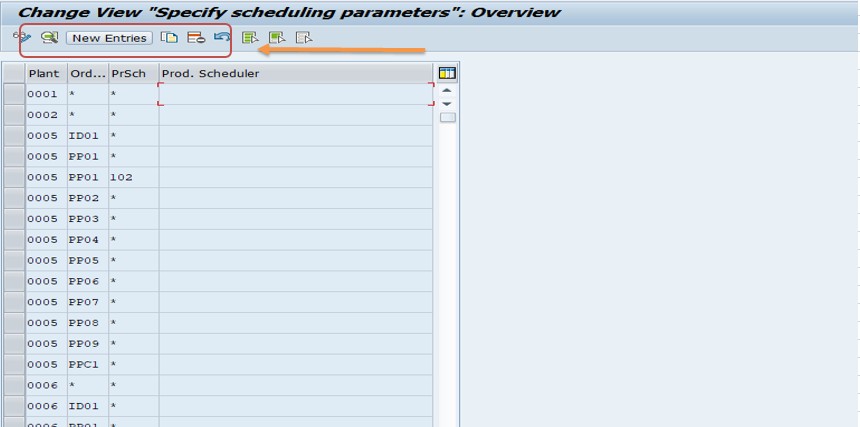

Run transaction OPU3 (Define Scheduling Parameters for Production Orders). It is also available in the IMG under Production, Shop Floor Control, Operations, Scheduling.

SAP transaction OPU3 define scheduling parameters for production orders
2

Choose the New Entries button to maintain a new line.

3

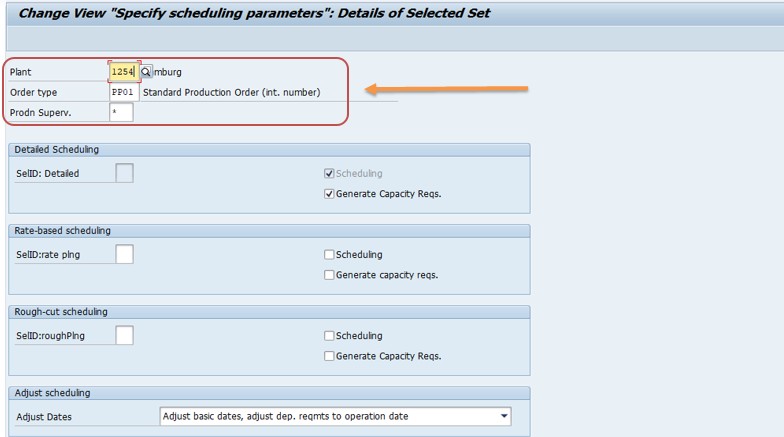

Enter the key fields. Select Plant 1254, Order Type PP01 (standard production order) and Production Supervisor *. The star means the entry applies to every production scheduler in that plant and order type.

4

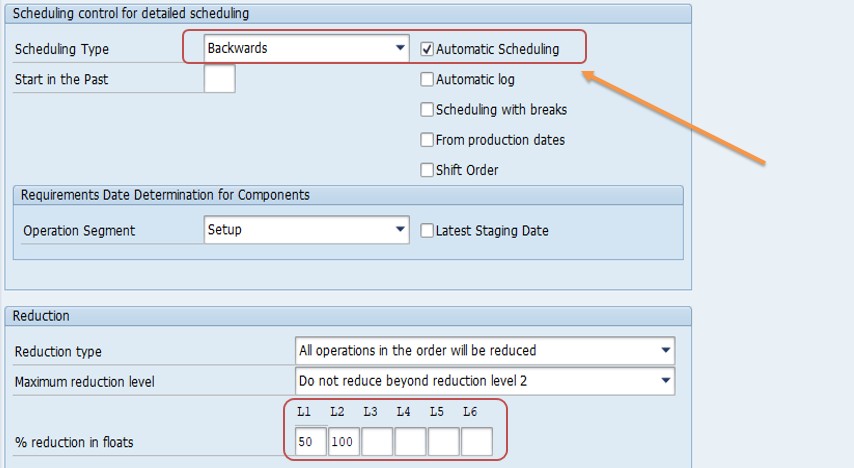

Maintain the scheduling parameters. Set the Scheduling Type to Backward and tick the Automatic Scheduling checkbox.

SAP OPU3 new entry for plant 1254 and order type PP01 with production supervisor star SAP OPU3 scheduling type backward and automatic scheduling ticked
5

Save your entry. If SAP asks for a Customizing request, enter an existing request or create a new one with a clear description, for example "Scheduling parameters plant 1254 order type PP01".

Important: An entry with a star for the production scheduler is easy to maintain, but it applies broadly. If different planners need different rules, create separate entries for them and keep the star entry as a fallback.

✅ How to Verify That the Fix Worked

If the test works in the quality system, transport the change to production. Include in the description which plant and order type are affected, so that the support team knows the reason later.

📅 Worked Example: What Backward Scheduling Does

A concrete example shows why the scheduling type matters. Assume plant 1254 works Monday to Friday and a production order for 100 pieces has a total lead time of five working days. The customer needs the goods finished on Friday 20 November 2026.

ItemBackwardForward
Starting pointFinish date, Friday 20 NovemberStart date, for example Monday 16 November
CalculatedStart date: Monday 16 NovemberFinish date: Friday 20 November
Question answeredWhen must we start to be ready on time?When will we be ready if we start now?

In the backward case SAP counts five working days back from the finish date, using the factory calendar of the plant, and arrives at Monday 16 November. If a public holiday fell in that week, the calculation would skip it and the start date would move earlier. In the forward case, SAP starts from the chosen start date and counts forward.

If the scheduling parameters were missing, SAP could do neither. With the entry in place, the dates are filled in automatically when the order is saved, as long as automatic scheduling is ticked. That is exactly the behavior planners expect.

💼 Real-World Scenario: A New Plant Goes Live with No Orders

This is an illustrative example based on a typical project. A manufacturer in Pune opened a new plant, 1254, and copied most settings from an existing plant. Master data was loaded over a weekend: materials, bills of material and routings. On Monday morning the first planner tried to create a production order with CO01 and received the message that scheduling parameters were not defined.

The SAP PP consultant opened OPU3 and found entries for the old plant, but none for 1254. She checked how the old plant was set up, discussed with the head of planning whether orders there were scheduled backward from the customer date, and created a new entry for plant 1254, order type PP01, with a star for the production scheduler, backward scheduling and automatic scheduling. She tested a sample order in the quality system, moved the transport to production and told the planner to try again.

The order was created within minutes. Afterwards the team added "scheduling parameters per plant and order type" to their go-live checklist for new plants, together with number ranges and the production scheduling profile. The same oversight never caused a delay again.

🔄 Master Data That Also Affects Scheduling

While OPU3 is the key to this error, several other settings influence how SAP schedules an order. Knowing them helps you tell a configuration problem from a data problem.

SettingWhere It Is MaintainedEffect on Scheduling
Production schedulerMaterial master, MRP 1 viewSelects the matching line in OPU3.
Production scheduling profileMaterial master, Work scheduling view (defined in OPKP)Proposes defaults such as underdelivery and overdelivery tolerances and the order type.
In-house production timeMaterial master, MRP 2 viewUsed for lead time when no routing times are available.
Scheduling margin keyMaterial master, MRP 2 viewAdds float before and after production.
Operation times and formulasRouting and work centerDetermine the duration of each operation.
Factory calendarPlant settingsDefines the working days used in the calculation.

Think of OPU3 as the rule book, and the other settings as the data the rules work with. If the rule book is empty, nothing works. If the data is wrong, SAP schedules, but the dates are not realistic. Both need attention.

🔄 Where Should You Make the Change?

SituationRecommended Action
Sandbox or training systemMake the change directly and test it.
Project landscape with DEV, QA and PRODChange in DEV, test in QA, then import the transport to PROD.
OPU3 is display-only in productionDo not look for a workaround. Raise a change request.
Production is blocked right nowFollow your emergency change process and document the reason.

If the error persists in production after the fix works in quality, check that the transport has been released and imported into the right client. Also compare the plant and order type values between the systems, in case a different order type is used in production.

❗ Common Mistakes When Fixing This Error

🔧 Troubleshooting: When the Fix Does Not Work

The error still appears after saving in OPU3

Check that the plant and order type in the entry are exactly those of the failing order. Then start a new session, since an open session may use old buffers.

It works for some planners but not for others

This points to the production scheduler. Compare the schedulers of the failing materials and make sure a star entry or a matching entry exists.

Works in quality but not in production

The transport may not be imported, or may be waiting in a queue. Compare the OPU3 entries in both systems.

The order is created but the dates are empty

Automatic scheduling may be off, or the routing may have no usable times. Check the entry in OPU3 and the operation data in the routing.

The dates look unrealistic

Review the factory calendar, the work center capacity and formulas, the scheduling margin key and the queue times. The parameters decide direction, not duration.

A different error appears after the fix

This is normal. The first error was hiding the next requirement, such as a missing routing, a closed period or a missing number range. Solve them one by one.

✅ How to Prevent This Error in the Future

💡 Best Practices for Scheduling Parameters

Once the error is fixed, a little discipline keeps the configuration clean. These habits come from projects where scheduling rules grew over many years and nobody remembered why each entry existed.

Start simple and refine later

Begin with one star entry per plant and order type, with a clear scheduling type and automatic scheduling. Add entries for individual production schedulers only when a real business need appears. A short list of rules is easier to explain, test and audit than a long list of exceptions.

Align the rules with the planning process

Scheduling parameters should reflect how the planners actually work. If the company plans from customer due dates, backward scheduling fits. If production runs continuously and the question is when material will be ready, forward scheduling may fit better. Sit with planners for an hour before you decide. That hour avoids months of manual date corrections.

Treat dates as a chain

The dates of an order depend on the scheduling parameters, the routing times, the work center capacity, the margin key and the factory calendar. A problem in any link gives unrealistic dates, even when the parameters are correct. When planners complain about dates, check the whole chain and not only OPU3.

Document every change

Record the plant, order type, scheduler, scheduling type, the reason and the person who agreed. This small note answers most questions that arise a year later.

🔒 Authorization Considerations

OPU3 is Customizing, so it is normally limited to consultants and a few key users, with transport rights controlled by the basis team. If you cannot change it, do not look for a way around the restriction. Send the support team the message, the plant, the order type, the scheduler and your proposed fix: "define scheduling parameters in OPU3 for plant 1254 and order type PP01 with backward scheduling and automatic scheduling". A precise request is processed faster than a screenshot alone.

📱 This Error in SAP S/4HANA

Production orders and their scheduling still exist in SAP S/4HANA, and the idea of scheduling parameters per plant and order type remains. In on-premise releases you will find the same Customizing path and a similar OPU3 screen. In cloud editions, configuration is usually done through guided activities, and production orders may be handled through Fiori apps. Names and options change with each release, so confirm the activity in your own system. The logic does not change: if SAP says that scheduling parameters are missing, create them for the plant and order type.

📋 Quick Fix Checklist

📋 Related SAP Transactions

TransactionPurpose
OPU3Define scheduling parameters for production orders.
OPKPDefine production scheduling profiles.
CO01 / CO02 / CO03Create, change or display a production order.
CO07 / CO08Create a production order without material or for a sales order.
MM02Maintain the material master, including MRP and work scheduling views.
CA02Change a routing.

🎓 Interview-Style Questions and Answers

Q: What are scheduling parameters?
Configuration entries that define how SAP schedules production orders for a plant, order type and production scheduler.

Q: Which transaction defines them?
OPU3.

Q: What is the difference between backward and forward scheduling?
Backward starts from the finish date and calculates the start. Forward starts from the start date and calculates the finish.

Q: What does the star in the production scheduler field mean?
It is a wildcard that applies to all schedulers.

Q: Is this error a master data problem?
No, it is a configuration problem. Master data may still affect the dates, but it does not cause this message.

Q: What is the production scheduling profile?
A profile from the material master Work scheduling view that proposes order defaults. It is defined in OPKP and is different from the scheduling parameters.

📚 Quick Glossary

🎯 Conclusion

"Scheduling parameters are not defined for production orders" is a configuration gap, not a master data fault. Find the plant, order type and production scheduler of the failing order, open OPU3, create a new entry with the right key, choose the scheduling type, for example Backward, tick Automatic scheduling and save with a transport. Then test with a real order and check the dates. Add this setting to your checklist for every new plant and order type, and the error will not trouble you again. If something still blocks you, send the details to pramod@learntosap.com and we will help you find the next step.

❓ Frequently Asked Questions

SAP cannot find a scheduling parameter entry for the combination of plant, order type and production scheduler of the order, so it does not know how to calculate the order dates.
Transaction OPU3, Define Scheduling Parameters for Production Orders. Create or correct the entry for the plant and order type.
The star is a wildcard. The entry then applies to every production scheduler in that plant and order type, unless a more specific entry exists.
Backward scheduling starts from the required finish date and works back to the start date, and is the usual choice when orders must be ready by a due date. Forward scheduling starts from a start date and calculates the earliest finish.
When it is switched on, SAP schedules the order automatically when it is created or changed, instead of waiting for the user to trigger scheduling manually.
Yes in most landscapes, because OPU3 is a Customizing transaction. Make and test the change in development or quality, then transport it to production.
